Case files · 29 September 2026
Latest File · Brickell & Brickell KeyFollowing a building in these files?Tell Josh which one. He’ll send its recorded sales from the Miami-Dade record, what is on the market there now …Open the files →
Josh Stein, Miami real estate associateJosh Stein

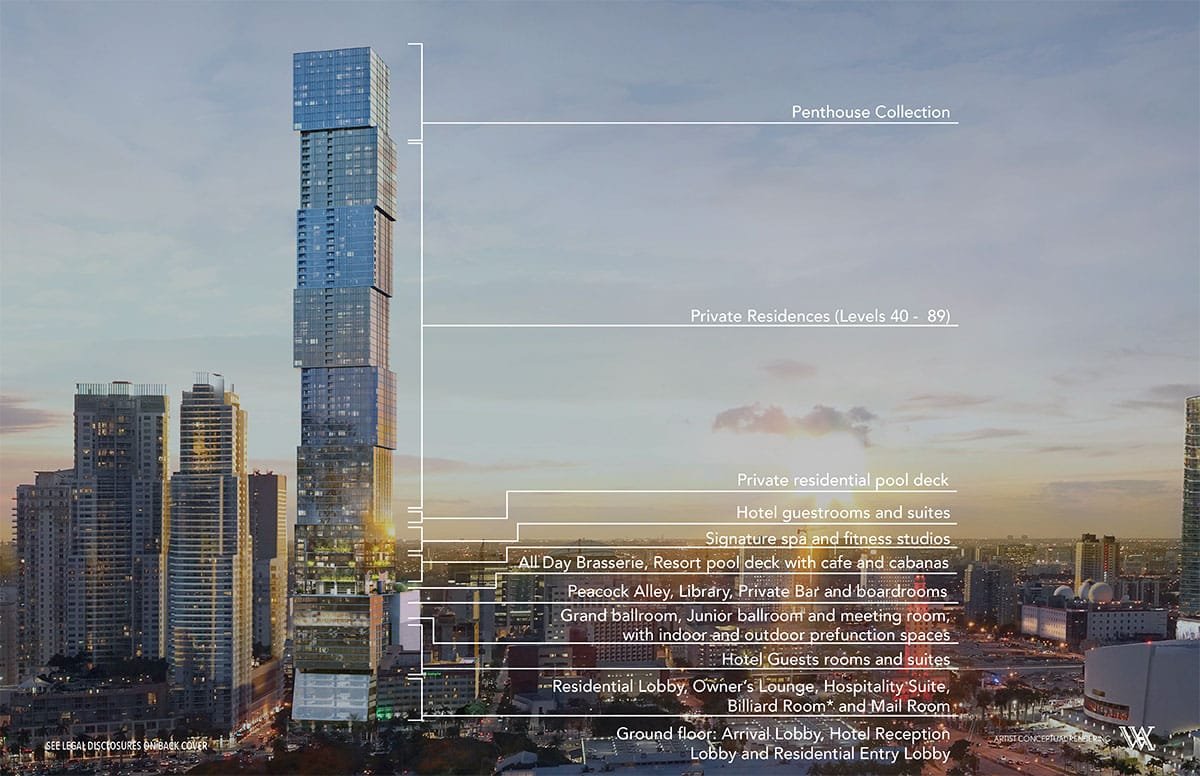

Waldorf Astoria Residences Miami — closeup of the tower's crown against the sky, artist conceptual rendering

Waldorf Astoria Miami

Leer en español →

South Florida New Construction · Downtown Miami · Waldorf Astoria Miami

360 or 387 residences, plus 205 hotel keys.

By Josh Stein · Florida license SL3057661 · Updated 26 September 2026

Verified 24 September 2026Florida YIMBY, Florida Trend, Miami New Times +12 more15 sources

Sources

1 / 7

Waldorf Astoria Residences Miami — closeup of the tower's crown against the sky, artist conceptual rendering

2 / 7

Waldorf Astoria Residences Miami — penthouse family room with downtown Miami skyline view, developer rendering

3 / 7

Waldorf Astoria Residences Miami — penthouse master bedroom with floor-to-ceiling bay views, developer rendering

4 / 7

Waldorf Astoria Residences Miami — penthouse dining room overlooking Biscayne Bay, developer rendering

5 / 7

Waldorf Astoria Residences Miami — wraparound balcony lounge with bay and island views, developer rendering

6 / 7

Waldorf Astoria Residences Miami — penthouse living room with fireplace and bay view, developer rendering

7 / 7

Waldorf Astoria Residences Miami — rooftop pool deck at dusk with bay view, developer rendering

Building facts

Address
300 Biscayne Blvd.
Neighborhood
Downtown Miami
Completion anticipated
Q2 2028 (Florida YIMBY, 27 August 2026)
Floors
100
Residences
387 (developer’s June 2024 financing release; Florida YIMBY); 360 (developer’s website)
Status
Under construction — superstructure at level 85 of 100 (Florida YIMBY, 27 August 2026)
Developers
Property Markets Group and Greybrook Realty Partners (with Mohari Hospitality, S2 Development, Hilton)
Architect
Carlos Ott, Sieger Suarez Architects
Pricing
$3.5 million to $50 million (Florida Trend, 7 August 2026)

Key Takeaways

  • 360 or 387 residences, plus 205 hotel keys — the developer has published both: 360 private residences in its 20 October 2022 groundbreaking release and on its website (read 24 September 2026), and 387 in its 14 June 2024 financing release. Florida YIMBY (25 February and 27 August 2026) reports 387 private condominium residences and 205 guest rooms; Florida Trend (7 August 2026) says 360 condos; Newsweek (7 May 2026) prints 387 residences in its summary and 360 residences of one to four bedrooms in the text. I have not found a source that says why the counts differ.
  • Nine offset glass cubes — Florida YIMBY (23 June 2024 and 27 August 2026) and Florida Trend (7 August 2026) count nine; Florida YIMBY’s 25 February 2026 update referred to ten.
  • Completion: 2028 from the developer and Hilton, 2027 only in a few places — the developer’s 14 June 2024 financing release says “Q2 2028”, Hilton (7 July 2026) says the hotel is slated to open in 2028, and a PMG managing partner told Newsweek (7 May 2026) the tower will be finished in 2028; Florida YIMBY (27 August 2026) says the second quarter of 2028. The 2027 figures are a phrase in Florida Trend (7 August 2026, “next year”) and PMG’s own corporate portfolio page, which Miami New Times (12 August 2026) reports lists 2027 while PMG’s statement to that paper gave no completion date. Early marketing pointed to around summer 2025.
  • Under construction, superstructure at level 85 of 100 — per a post dated 23 August 2026 that Florida YIMBY reported on 27 August 2026, along with a site banner advertising that the tower will top off this winter.
  • $668,000,000 construction loan — from Bank OZK and Related Fund Management in June 2024, reported by Florida YIMBY as the largest ever for a residential condominium development in Florida.
  • $3.5 million to $50 million, and “well over 90% sold” — the price range is from Florida Trend (7 August 2026); the sales claim is PMG’s own statement to Miami New Times (12 August 2026). I have not found an independent count.
  • Four Block 83 folios are classified vacant land — VACANT LAND – COMMERCIAL, assessed at $25,655,100 for 2026 (Miami-Dade Property Appraiser, pulled 24 September 2026). The roll also shows a recorded condominium named X MIAMI CONDO on neighbouring lots; I have not found a source that says how it relates to the tower.

Waldorf Astoria Miami, by the numbers

100Storeys
360–387Residences (sources differ)
Q2 2028Completion anticipated
Under ConstructionStatus

Developers: Property Markets Group and Greybrook Realty Partners · Architects: Sieger Suarez Architects with Carlos Ott · Residences: 387 per Florida YIMBY, 360 per the developer’s website (read 24 September 2026) · Prices: $3.5 million to $50 million (Florida Trend, 7 August 2026) · Completion: Q2 2028 per Florida YIMBY, 27 August 2026; some sources say 2027.

300 Biscayne Blvd, Miami, Florida 33132 | Neighborhood: Downtown Miami

This page sets out what dated sources say about the Waldorf Astoria Hotel & Residences Miami, including the places where they disagree: the residence count (360 or 387), the completion date (2027 or 2028) and what the county roll shows for the site. Each figure carries its source and date, and I re-read them on 24 September 2026. Where I could not close a question I say so rather than pick the tidier answer.

What is actually being built at 300 Biscayne

The Waldorf Astoria Hotel & Residences Miami is a 100-storey, 1,049-foot tower at 300 Biscayne Boulevard in Downtown Miami (Florida YIMBY, 27 August 2026). Florida YIMBY calls it Florida’s first supertall and, in June 2024, described it as the tallest residential building south of New York City; the developer’s website says it will be the tallest hotel and residential tower south of Manhattan.

The programme is 387 private condominium residences and 205 hotel guestrooms and suites according to Florida YIMBY (23 June 2024, 25 February 2026 and 27 August 2026). The developer’s own website says 360 branded luxury residences (read 24 September 2026), and Florida Trend (7 August 2026) also reports 360 condos alongside 205 hotel rooms and suites. I have not found a source that says why the counts differ or which is current, so confirm the count in the offering documents you are given.

The design is nine offset glass cubes. Florida YIMBY (23 June 2024 and 27 August 2026) and Florida Trend (7 August 2026) each count nine, and Florida Trend says the first three cubes are the hotel and the top six are the condominium. Florida YIMBY’s 25 February 2026 update instead referred to “the sixth of the tower’s ten stacked cubic volumes”; its 27 August 2026 update, the latest I found, describes eight of nine cubes as structurally legible. I have not found a source that explains the difference.

By the credits reported, the tower is designed by Sieger Suarez Architects in collaboration with Carlos Ott, with interiors by BAMO; the developers are Property Markets Group and Greybrook Realty Partners, with Mohari Hospitality, S2 Development and Hilton; and the general contractor is John Moriarty & Associates (Florida YIMBY, 27 August 2026). The developer’s website disclaimer (read 24 September 2026) says the Residences are not owned, developed or sold by Hilton, and that the Waldorf Astoria name is used under a limited, non-exclusive licence from Hilton that may be terminated or may expire without renewal.

The tower is on Biscayne Boulevard. Florida Trend (7 August 2026) describes the site as a parcel opposite Bayfront Park with an unobstructed view of Biscayne Bay and Miami Beach.

Downtown Miami skyline, the district around 300 Biscayne Boulevard
Downtown Miami. The Waldorf Astoria site sits on Biscayne Boulevard opposite Bayfront Park.

Where construction stands

The concrete superstructure passed the 50th floor in December 2025 (Miami New Times, 12 August 2026) and the 60th floor by 25 February 2026, when Florida YIMBY reported crews averaging approximately one floor every ten days. Florida Trend, in a feature published 7 August 2026, described the highest floor built in May 2026 as the 72nd and said a new storey was poured about once a week. In its statement to Miami New Times (12 August 2026), PMG said the tower was “now surpassing 870 feet”.

Latest report: level 85 of 100. On 27 August 2026 Florida YIMBY reported that the superstructure had reached level 85, citing a post dated 23 August 2026, with concrete work begun on the ninth and final cube and curtain wall installation progressed through the seventh cube. It also reports a new site banner advertising that the tower will top off “this winter”, and about 25 additional levels in roughly six months since its February report. Capform is delivering the concrete scope under general contractor John Moriarty & Associates.

In June 2024 the development secured a $668,000,000 construction loan from Bank OZK and Related Fund Management, which Florida YIMBY (23 June 2024) reported as the largest ever for a residential condominium development in Florida.

PMG told Miami New Times (12 August 2026) that the project is “well over 90% sold”, with remaining inventory limited to Sky Collection residences. PMG’s managing partner told Florida Trend (feature of 7 August 2026) that, as of May 2026, sales were “just shy of a billion” dollars with 26 units remaining, and that buyers on average put down a 40% deposit; Florida Trend reports condo prices from $3.5 million to $50 million. These are developer statements: a sell-through figure describes contracts signed and deposits taken, not closings, and I have not found an independent count.

Which completion date should a buyer believe?

Sources disagree on when the building will be finished. Miami New Times (12 August 2026) traced the completion date through the project’s public statements; I have added the Florida YIMBY, Hilton and Florida Trend statements I read myself.

Stated byWhenCompletion given as
Early brokerage marketing (per Miami New Times)2021Around summer 2025
Greybrook (per Miami New Times)January 20222026
Financing announcement (Florida YIMBY, 23 June 2024)June 2024Q2 2028
Florida YIMBY25 February 20262028
Hilton press release7 July 20262028
Florida Trend feature7 August 2026“Next year” (2027)
PMG portfolio page (per Miami New Times)reported 12 August 20262027
Florida YIMBY27 August 2026Q2 2028

Miami New Times (12 August 2026) reported that public marketing and development-partner statements from 2021 pointed to completion in 2025 or 2026, and that third-party listing pages show still other dates, including January 2028. Most of the sources I read give 2028 (Q2 2028 in Florida YIMBY’s latest report); two point to 2027. Miami New Times also reported that PMG’s portfolio page lists the building as 93 floors rather than 100.

PMG’s response to Miami New Times was that “construction continues to progress as scheduled”, with the tower surpassing 870 feet and the project well over 90% sold. Miami New Times reported that the statement did not explain the shifting completion dates or why PMG’s portfolio page continues to list 2027. I am setting out both so a buyer can weigh them.

What I can and cannot source. I can source the loan, the progress figures above and PMG’s sell-through statements. I have not found a source that says why the completion date moved. Under Florida’s condominium act (section 718.504, 2026 Florida Statutes, read 24 September 2026) the offering circular must state the estimated latest date of completion or point to the purchase-agreement clause that does, so the date in your own contract is the one to read, along with the outside date, what happens if it passes and what notice the developer owes you. I track delivery slippage across the market on the Miami pre-construction delivery tracker.

What does the county say about the ground under it?

The tower site is on Block 83 of MIAMI NORTH, plat book B-41. As of 24 September 2026 the Miami-Dade County Property Appraiser records four folios there as follows. All four are recorded to PMG Downtown Developers LP, and folio 01-0108-030-1190 carries the county site address 300 BISCAYNE BLVD. All four also carry a deed dated 7 November 2014 at $80,000,000, which matches the $80 million that Florida Trend (7 August 2026) and Miami New Times (12 August 2026) report PMG paying for the site that year.

FolioLotCounty classification2026 assessed
01-0108-030-116017VACANT LAND – COMMERCIAL$4,248,750
01-0108-030-117018VACANT LAND – COMMERCIAL$4,248,750
01-0108-030-118019 & 21VACANT LAND – COMMERCIAL$10,603,200
01-0108-030-119020VACANT LAND – COMMERCIAL$6,554,400
Total$25,655,100

All four are classified VACANT LAND – COMMERCIAL, with a combined 2026 assessed value of $25,655,100. I have not found a source that says when the appraiser will reclassify them.

Part of the assemblage sits under a recorded condominium. A fifth Block 83 parcel — lot 16, folio 01-0108-030-1150, classified PARKING LOT — assesses at $0. Its legal description carries an NAU (Now Assessed Under) pointer to folio 01-0108-030-1040 (lots 5 through 7 and 14 through 16, also $0), which points in turn to reference folio 01-4137-076-0001. The county labels that folio X MIAMI CONDO and describes it as lots 5 through 7 and 14 through 16 of Block 83 as described in a declaration recorded at Official Records book 31146, page 1639. Under it the county lists two units, at the site addresses 230 NE 4 ST and 243 NE 3 ST: a residential unit (99.16% of the common elements) assessed at $101,970,000 for 2026, and a retail unit (0.84%) assessed at $2,160,859. The roll does not say how X MIAMI CONDO relates to the Waldorf Astoria tower and I have not found a source that does. A $0 on the roll is a pointer, not a valuation.

What that means in practice: the county shows a single residential unit under that condominium, not 360 or 387 individual residences, so I could not look up an individual residence by folio, and any tax figure you are shown for one is a projection rather than an assessment.

The assemblage’s recorded sale history (county record, 24 September 2026): a 1 April 2004 deed at $16,500,000 and a 5 May 2005 deed at $31,750,000, both flagged qualified and both recorded as deeds including more than one parcel, appear on all five Block 83 folios I pulled; a 1 November 1982 deed at $2,500,000, also qualified and multi-parcel, appears on the lot 16 folio and on folio 01-0108-030-1040. Then, on 7 November 2014, a deed at $80,000,000.

That 2014 deed carries the county classification “Trustees in bankruptcy, executors or guardians” and is flagged unqualified. It is a single county classification code covering several situations — a bankruptcy trustee, an executor of an estate, a guardian — and it does not say which one applied. Miami New Times (12 August 2026) reports that PMG acquired the site for $80 million in 2014 through a court-ordered sale following years of receivership litigation, rather than a bankruptcy sale. What the county record itself establishes is the code, the date and the amount.

What I would verify before signing

Pre-construction diligence at this level is short, specific and mostly about documents rather than renderings.

The delivery date in your own contract. Not the marketing date, not the date on any page including this one. Find the outside date, what happens if it passes, and what notice the developer owes you. Given the range of dates in the table above, this is the single highest-value thing to read.

The deposit schedule and where the money sits. PMG’s managing partner told Florida Trend (7 August 2026) that buyers on average put down a 40% deposit. Confirm your own schedule, and confirm in the contract and offering circular how much of your deposit is held in escrow and how much the developer may use for construction.

What “well over 90% sold” is measuring. Ask whether that is reservations, executed contracts or closings, and ask for it in writing. It is a reasonable question and the answer tells you something either way.

The hotel-residential relationship. This is a Waldorf Astoria hotel and a condominium sharing one tower, and the documents that split shared costs between them are worth reading before you buy rather than after. The Real Deal (5 August 2026) describes disputes between unit owners and commercial-space owners at a number of South Florida condo-hotels. Read the declaration’s allocation of common expenses and any shared-facilities agreement, and ask specifically how hotel-side costs can reach residential owners.

A note on the developer, stated as record rather than as a view. The Real Deal reported on 5 August 2026 that affiliates of PMG and the condominium association at a different PMG building — the Elser Hotel & Residences at 398 NE 5th Street, a 49-storey, 646-unit condo-hotel that PMG completed in 2022 — had sued each other in July and August 2026: the association on 6 July (assessments and the governing documents) and 24 July (breach of contract), and PMG affiliates on 31 July and 2 August. The association alleges that a PMG affiliate breached a November 2025 settlement over parking-garage revenue and operator approval; the PMG affiliate alleges, among other things, that the association is withholding roughly $773,000 in hotel management fees and billing quarterly assessments at the 2025 rate. The association’s board president told The Real Deal that the $773,000 figure reflects collected receivables and that the PMG affiliate owes the association money, and a statement on behalf of the PMG affiliate said it strongly disputes the association’s claims about the parking operator. These are allegations in complaints, not findings. The article does not involve the Waldorf Astoria project; I include it because it is on the public record, concerns the same developer and concerns the hotel-versus-association cost structure a buyer here should be reading about.

Who this building suits. A buyer who wants a branded, serviced residence in a landmark tower, who is comfortable with a 2028 horizon, and who is buying to hold. Who it suits badly: anyone whose plan needs the keys before 2028, anyone underwriting a resale before completion, and anyone who has not read the shared-facilities documents. And if you are already holding a contract here and considering an assignment, every buyer can see the same completion-date history you can, so I would price the file against that rather than against the original 2025 marketing.

In the research: The W South Beach Closes 20 August. What That Means for the 173 People Who Own Units There

Waldorf Astoria Miami — Frequently Asked Questions

When will Waldorf Astoria Miami be completed?

Florida YIMBY’s latest report (27 August 2026) says the second quarter of 2028, and Hilton’s 7 July 2026 release says the downtown Waldorf Astoria is slated to open in 2028. Two sources I read point to 2027: Florida Trend’s 7 August 2026 feature wrote “next year”, and, per Miami New Times (12 August 2026), PMG’s own portfolio page lists 2027. Early marketing said around summer 2025. The date that governs your purchase is the one in your contract.

How many residences does Waldorf Astoria Miami have?

The sources disagree. Florida YIMBY (June 2024, 25 February and 27 August 2026) reports 387 private condominium residences plus 205 hotel guest rooms; the developer’s website (read 24 September 2026) and Florida Trend (7 August 2026) say 360 residences. I have not found a source that explains the difference, so confirm the count in the offering documents you are given.

How tall is the Waldorf Astoria Miami tower?

100 storeys and 1,049 feet, per Florida YIMBY (27 August 2026), which calls it Florida’s first supertall. That article reports the superstructure at level 85, citing a post dated 23 August 2026, and a site banner advertising topping off this winter; the superstructure had passed the 60th floor by 25 February 2026.

How many cubes make up the tower?

Nine. Florida YIMBY (23 June 2024 and 27 August 2026) and Florida Trend (7 August 2026) count nine offset glass cubes. Florida YIMBY’s 25 February 2026 update referred to “the sixth of the tower’s ten stacked cubic volumes”, and I have not found a source that explains the difference; its 27 August 2026 update, the latest I found, counts nine.

What do the residences cost, and how much is left?

Florida Trend (7 August 2026) reports condos ranging from $3.5 million to $50 million. PMG told Miami New Times (12 August 2026) that the project is “well over 90% sold”, with remaining inventory limited to Sky Collection residences. Those are developer statements, and the developer’s website says prices are subject to change without notice, so confirm current availability and pricing directly.

What does the county roll show for the site?

As pulled on 24 September 2026, four Block 83 folios recorded to PMG Downtown Developers LP are classified VACANT LAND – COMMERCIAL, with a combined 2026 assessed value of $25,655,100. Neighbouring lots 5 through 7 and 14 through 16 sit under a recorded condominium the county labels X MIAMI CONDO (declaration at Official Records book 31146, page 1639), with a residential unit assessed at $101,970,000 and a retail unit at $2,160,859 for 2026. I have not found a source that says how that condominium relates to the tower.

What was the $80,000,000 sale in 2014?

A deed recorded 7 November 2014 across the assemblage at $80,000,000, flagged unqualified and carrying the county classification “Trustees in bankruptcy, executors or guardians”, a single code covering several situations. Florida Trend (7 August 2026) and Miami New Times (12 August 2026) both report PMG paying $80 million for the site in 2014; Miami New Times says it was a court-ordered sale following years of receivership litigation rather than a bankruptcy sale.

Sources and further reading

Waldorf Astoria Miami Hotel & Condo Residences Amenities

As described on the developer’s website (read 24 September 2026):

• 100-storey tower in Downtown Miami with views of the downtown skyline, Miami Beach and the Atlantic Ocean
• Third-level residential lobby with the concierge and recreation space
• Peacock Alley, centred on a signature pendulum clock
• Immersive resort pool with outdoor café and private cabanas
• Private bar and wine tasting room, a signature restaurant and an all-day dining brasserie
• Meeting venue with spaces from ballrooms to boardrooms
• Kids club
• Signature spa with a fitness centre, wellness lounges, saunas, steam and treatment rooms
• Residents’ hotel benefits that include house-account signing privileges and preferred access to the spa and other hotel venues
• Interiors by BAMO; kitchens with custom Italkraft cabinetry and a Sub-Zero and Wolf appliance package; Waterworks and Duravit bathroom fixtures; smart-home technology; floor-to-ceiling windows up to 11 feet
• Fully finished one- to four-bedroom residences, plus fully finished and furnished Junior Suites

Florida YIMBY (23 June 2024) lists the private residential amenities as an owners-only lobby and lounge, a hospitality suite, a billiard room, a kids club and an elevated pool deck. The developer’s disclaimers say that improvements and amenities depicted may not exist and that plans and specifications are subject to change without notice.

https://youtu.be/EaZEYERynbs

Waldorf Astoria Miami Hotel & Condo Residences Prices

$3.5 million to $50 million for the condos — Florida Trend, 7 August 2026 (that feature reports 360 condos and 205 hotel rooms and suites). PMG told Miami New Times on 12 August 2026 that the project is well over 90% sold and that remaining inventory is limited to Sky Collection residences priced by residence type, size and elevation. PMG’s managing partner told Florida Trend that 26 units remained as of May 2026 and that buyers on average put down a 40% deposit. The developer’s website says prices, plans and specifications are subject to change without notice.

I have not found a current published price list by unit type or a published deposit schedule. Ask me for what is still available and for the deposit terms in the current contract form.



Thinking about Waldorf Astoria Miami?

I have sold South Florida property since 2002, more than $1 billion of it. Ask me for the recorded declaration, what has genuinely closed, or a straight answer on whether this building fits what you are after.

Call (305) 695-8257Send me a question

Josh Stein · Florida real estate sales associate, license SL3057661 · (305) 695-8257 · hello@joshsteinrealtor.com
Ask me about Waldorf Astoria Miami300 Biscayne Blvd.WhatsAppContact

Get this building’s public record before you put down a deposit

  • Its permits, approvals and construction status as they appear in city and county filings, each with its filing date.
  • An alert when the status changes, and when the first closed sales in the building are recorded.
  • No sales pitch, no inventory blasts. One building, and only what the public record shows.

Get the building record

Tell Josh which building. He’ll send what the filings show and let you know when it changes.

Direct line

Ask Josh a question

Tell me the building, the budget and the timeline. You will get an honest read — including when the answer is that you should not buy it.

+1 (305) 695-8257 · hello@joshsteinrealtor.comPhone or WhatsApp · English / Español · Licensed in Florida since 2002

The Miami Confidential

The reporting, every two weeks.

Every new case file. Every delivery date that moves. Every figure dated and sourced. No listings, no hype, no press releases dressed up as news.

Free, every two weeks. Pick one or both. Unsubscribe in one click.
