Building facts
- Address
- 3162 Commodore Plaza
- Neighborhood
- Coconut Grove
- Year built
- 2025
- Floors
- 7
- Residences
- 54
- Status
- On Hold
- Developer
- Location Ventures
- Architect
- Arquitectonica
- Pricing
- Starting at $750,000
Verified 24 August 2026Florida YIMBY, The Real Deal, Kozyak Tropin & Throckmorton +1 more6 sources
Urbin Coconut Grove — photography to follow

Key Takeaways
- This is not new construction on cleared land — it is a conversion. — The county carries the site as 48 existing folios under a recorded 2016-era commercial condominium declaration, COMMODORE CENTRE CONDO, that Urbin is converting alongside new ground-up building, matching Florida YIMBY’s own description of the project.
- The developer’s CEO pleaded guilty to federal charges on 14 May 2026, and this project is inside the case. — The developer’s CEO pleaded guilty to money laundering and payroll tax conspiracy charges, in a case prosecutors describe as an $85 million fraud scheme (The Real Deal, 14 May 2026). URBIN Coconut Grove Partners LLC is named among 20 entities under a court-appointed receivership in the related SEC case (Case No. 23-24903-CIV-JB, S.D. Fla.).
- A federal receiver’s own status report describes the residential floors as gutted, not paused. — A filing dated 10 September 2025 states plainly: “The residential units of 3162 Commodore Plaza occupy the fourth through sixth floors and these floors have been gutted.” The same filing states: “Construction ceased in the summer of 2023. Plywood is used to cover the window openings, and flooring and tiles have been removed.”
- The Receiver is seeking court approval to sell the property for $28.2 million. — Urbin Coconut Grove Partners LLC holds the Commodore Properties through four subsidiary entities, per the same 10 September 2025 status report — Urbin Commodore Residential SPE LLC (3162 Commodore Plaza units), Urbin Commodore Residential II SPE LLC (3170 Commodore Plaza), Urbin Commodore SPE LLC (3138 Commodore Plaza leaseholder), and Urbin Commodore Restaurant SPE LLC (3120 Commodore Plaza leaseholder).
- The City of Miami’s Unsafe Structure Panel has cited the property for structural violations. — The same status report notes the properties require substantial remediation and that the Commodore Companies lack the funds for construction, condominium-association fees, or maintenance.
- The building was reported 90 percent sold at its 25 January 2023 groundbreaking , per Florida YIMBY — nearly two and a half years before the status report above. What, if anything, that pre-sale figure means today is not established by any source used in this research.
Urbin Coconut Grove, by the numbers
Developer: Location Ventures · Architect: Arquitectonica. Source: the building record on this site.
3162 Commodore Plaza, Coconut Grove, Florida 33134 | Neighborhood: Coconut Grove
Urbin Coconut Grove — Building Facts
- Address
- 3162 Commodore Plaza, Coconut Grove, Miami, FL 33133
- Land Parcel
- 48 existing folios under the recorded declaration COMMODORE CENTRE CONDO (Miami-Dade Property Appraiser)
- Original Developer
- Location Ventures / URBIN Coconut Grove Partners LLC
- Architect
- Arquitectonica and Paredes Architects
- Interior Design
- am studio
- General Contractor
- Winmar Construction Inc.
- Original Sales Brokerage
- ONE Sotheby’s International Realty
- Planned Residences
- 54, studio to six-bedroom, 331–2,352 sq ft
- Groundbreaking
- 25 January 2023; reported 90% sold at that time (Florida YIMBY)
- Construction Ceased
- Summer 2023, per the Receiver’s 10 September 2025 status report
- Federal Civil Case
- The SEC receivership case, Case No. 23-24903-CIV-JB (S.D. Fla.); receiver Bernice C. Lee; URBIN Coconut Grove Partners LLC named among 20 receivership entities
- Federal Criminal Case
- The developer’s CEO pleaded guilty on 14 May 2026 to money laundering and payroll tax conspiracy charges, in a case prosecutors describe as an $85 million fraud scheme; sentencing scheduled August 2026
- Current Building Condition
- Gutted, not paused. The Receiver’s 10 September 2025 status report: “The residential units of 3162 Commodore Plaza occupy the fourth through sixth floors and these floors have been gutted.” “Plywood is used to cover the window openings, and flooring and tiles have been removed.”
- Ownership Structure
- Four subsidiary entities under URBIN Coconut Grove Partners LLC: Urbin Commodore Residential SPE LLC (3162 Commodore Plaza units), Urbin Commodore Residential II SPE LLC (3170 Commodore Plaza), Urbin Commodore SPE LLC (3138 Commodore Plaza leaseholder), Urbin Commodore Restaurant SPE LLC (3120 Commodore Plaza leaseholder)
- Proposed Sale
- The Receiver is seeking court approval to sell the Commodore Properties for $28.2 million
- City Violations
- The City of Miami’s Unsafe Structure Panel has cited structural violations; the Receiver’s report states the property requires substantial remediation and the Commodore Companies lack funds for construction, association fees, or maintenance
- Status
- Not a normal active pre-construction project. Construction ceased in 2023, the Receiver’s own status report describes the residential floors as gutted, the developer entity is under federal receivership, its CEO has pleaded guilty to money laundering and payroll tax conspiracy charges in a case prosecutors describe as an $85 million fraud scheme, and the Receiver is seeking court approval to sell the property outright.
- Est. Completion
- Not applicable under the current ownership and condition — omitted rather than estimated
Verified 24 August 2026 against Florida YIMBY (31 Jan 2023, Oscar Nunez), The Real Deal (14 May 2026, 20 Jul 2026), the Receiver’s Status Report in the SEC receivership case, Case No. 23-24903-CIV-JB, S.D. Fla. (filed 10 Sep 2025, read directly), and the Miami-Dade Property Appraiser (3162 Commodore Plaza, 48 folios, retrieved 24 Aug 2026).
What Was Planned at Urbin Coconut Grove
Urbin Coconut Grove was announced as a mixed-use, 54-residence project at 3162 Commodore Plaza, two blocks from CocoWalk in the heart of Coconut Grove. Developer Location Ventures broke ground on 25 January 2023 with Miami Mayor Francis Suarez and then-City Commissioner Ken Russell attending the ceremony (Florida YIMBY, 31 Jan 2023). The architecture was credited jointly to Arquitectonica and Paredes Architects, with interiors by am studio and general contracting by Winmar Construction Inc. Sales were originally handled by ONE Sotheby’s International Realty, and Florida YIMBY reported the building already 90 percent sold at groundbreaking.
The building was planned across an unusually wide range of unit types: 54 residences running from 331-square-foot studios to 2,352-square-foot six-bedroom homes, marketed designer-finished and furnished under Location Ventures’ Urbin brand — flexible short- or long-term-rental residences combined with coworking space (URBIN Work), wellness programming, food and beverage and ground-floor retail. All of the above describes the plan as marketed at groundbreaking in January 2023. It does not describe the building today — read on.

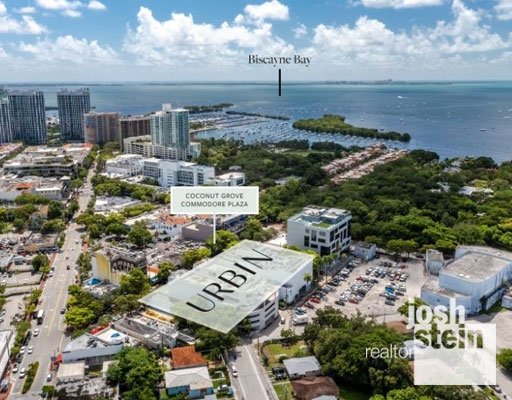

The Site Was Already a Condominium — Here Is What the County Shows
3162 Commodore Plaza is not raw land. The Miami-Dade Property Appraiser carries the address under 48 separate folios, all recorded under a single declaration, COMMODORE CENTRE CONDO. Two folios checked in detail (01-4121-131-0010 and -0020) are classified STORE: CONDOMINIUM – COMMERCIAL, sized 1,341 and 1,052 square feet, with 2026 assessed values of $526,610 and $413,120 respectively. Both carry a recorded sale dated 1 March 2016 at $1,500,000, flagged by the county as a multi-parcel transaction on a single deed of sale — consistent with an investor or developer assembling multiple commercial units in one transaction nearly seven years before Urbin’s groundbreaking. This detail is unchanged by anything below: whatever happens to the Urbin project, the underlying 48-folio commercial condominium declaration is the recorded structure of the site.
The Federal Case This Project Is Now Inside
Location Ventures and its CEO became the subject of an SEC civil action — the SEC receivership case, Case No. 23-24903-CIV-JB, U.S. District Court, Southern District of Florida — with the court appointing Bernice C. Lee as receiver over 20 named Location Ventures entities. URBIN Coconut Grove Partners LLC is one of them, named directly, alongside sister entities for Urbin’s Miami Beach and Coral Gables projects and the Villa Valencia development in Coral Gables. A permanent injunction was entered against the company’s CEO on 20 November 2024. The CEO resigned from Location Ventures in July 2023, and the firm announced it would liquidate assets to pay creditors.
The civil case was followed by a criminal one. The Real Deal reported on 14 May 2026 that the company’s CEO pleaded guilty to money laundering and payroll tax conspiracy charges, in a case federal prosecutors describe as an $85 million fraud scheme — the CEO admitted misappropriating investor funds across the company’s failed real estate projects and, specifically, unlawfully using $10.6 million in deposits from preconstruction condo buyers. Sentencing is scheduled for August 2026, with reporting indicating a sentence of at least 10 years in prison. Separately, on 20 July 2026, The Real Deal reported that buyers at the company’s projects — 38 of them at the sister Urbin Miami Beach project specifically — were approved to recover a partial share of lost deposits from a receivership fund distribution. This research did not find a parallel, project-specific deposit-recovery figure reported for Urbin Coconut Grove buyers by name; if a reader holds a contract or deposit here, the receivership docket is the accurate place to check, not this page.
What the Receiver’s Own Report Says About the Building Today
A status report filed by the Receiver on 10 September 2025, in the same federal receivership case, describes the building’s current physical condition directly. Quoted verbatim: “The residential units of 3162 Commodore Plaza occupy the fourth through sixth floors and these floors have been gutted.” And: “Construction ceased in the summer of 2023. Plywood is used to cover the window openings, and flooring and tiles have been removed.” That is a materially different condition from “under construction” or “paused” — it describes work that had been done being stripped out, not work waiting to resume.
The same report states that Urbin Coconut Grove Partners LLC holds the property through four subsidiary entities — Urbin Commodore Residential SPE LLC (the 3162 Commodore Plaza residential units), Urbin Commodore Residential II SPE LLC (3170 Commodore Plaza), Urbin Commodore SPE LLC (3138 Commodore Plaza, a leasehold interest), and Urbin Commodore Restaurant SPE LLC (3120 Commodore Plaza, a leasehold interest) — which resolves an otherwise-confusing detail in older press coverage: a separate 2023 report of investor allegations tied to “3138 Commodore Plaza” was not a different project, but a different address within this same assemblage. The Receiver is seeking court approval to sell the Commodore Properties for $28.2 million. The report also states the City of Miami’s Unsafe Structure Panel has cited structural violations at the property, that substantial remediation is required, and that the Commodore Companies lack the funds for construction, condominium-association fees, or ordinary maintenance.
Who Should — and Should Not — Consider This Building Today
As of this research, Urbin Coconut Grove is not a pre-construction purchase decision at all — it is a distressed asset in a federal receivership, cited for unsafe-structure violations, that the Receiver is actively trying to sell. No pricing, unit-availability, or completion-date information from the original 2023 marketing campaign describes the building’s current state, and none should be relied on. Anyone with an existing contract, reservation or deposit tied to this project should direct questions to the court-appointed receiver, Bernice C. Lee, through the SEC receivership case docket (Case No. 23-24903-CIV-JB, S.D. Fla.) rather than to Location Ventures, ONE Sotheby’s, or any other party associated with the original sales program. For a buyer simply researching Coconut Grove new construction broadly: this specific address is not a live opportunity today under its current ownership, whatever a future buyer of the distressed asset eventually does with the site.
Urbin Coconut Grove — Frequently Asked Questions
Is Urbin Coconut Grove still an active pre-construction project?
No. Construction ceased in the summer of 2023. A Receiver appointed in a federal SEC case (Case No. 23-24903-CIV-JB), reported on 10 September 2025 that the building’s 4th through 6th residential floors “have been gutted,” and is seeking court approval to sell the property for $28.2 million.
What did the original plan for Urbin Coconut Grove include?
54 residences at 3162 Commodore Plaza, from 331-square-foot studios to 2,352-square-foot six-bedroom homes, reported 90 percent sold at a 25 January 2023 groundbreaking. This describes the marketed plan as of that date — it does not describe the building’s condition today.
Is the building built on vacant land?
No. The Miami-Dade Property Appraiser carries 3162 Commodore Plaza under 48 folios recorded as an existing commercial condominium, COMMODORE CENTRE CONDO, dating to at least 2016. Urbin was planned as a conversion of that existing structure combined with new ground-up construction.
What happened to the developer?
In 2023 Location Ventures faced an SEC civil action (Case No. 23-24903-CIV-JB, S.D. Fla.) and a court-appointed receiver, Bernice C. Lee, took control of 20 related entities, including URBIN Coconut Grove Partners LLC by name. In May 2026, Location Ventures’ founder pleaded guilty to money laundering and payroll tax conspiracy charges, in a case prosecutors describe as an $85 million fraud scheme; sentencing is scheduled for August 2026.
What condition is the building in right now?
The Receiver’s own 10 September 2025 status report states: “The residential units of 3162 Commodore Plaza occupy the fourth through sixth floors and these floors have been gutted,” and “Construction ceased in the summer of 2023. Plywood is used to cover the window openings, and flooring and tiles have been removed.” The City of Miami’s Unsafe Structure Panel has also cited the property for structural violations.
Is the property for sale?
The Receiver is seeking court approval to sell the Commodore Properties — which Urbin Coconut Grove Partners LLC holds through four subsidiary entities covering 3162, 3170, 3138 and 3120 Commodore Plaza — for $28.2 million, per the 10 September 2025 status report. As of that filing the sale was proposed and awaiting court approval, not closed.
If I put a deposit down at Urbin Coconut Grove, what should I do?
Contact the court-appointed receiver, Bernice C. Lee, through the SEC’s case docket (Case No. 23-24903-CIV-JB, S.D. Fla.), not the original developer or sales brokerage. This research did not find a project-specific deposit-recovery announcement for Urbin Coconut Grove buyers by name, unlike the sister Urbin Miami Beach project, where 38 buyers were reported approved for partial refunds in July 2026.
Sources and further reading
- Florida YIMBY — “Construction Begins On URBIN Coconut Grove At 3162 Commodore Plaza In Miami” (31 Jan 2023, Oscar Nunez)floridayimby.com
- The Real Deal — “Developer Rishi Kapoor Pleading Guilty in $85M Fraud Case” (14 May 2026)therealdeal.com
- The Real Deal — “Buyers at Rishi Kapoor’s condo projects could get share of $4M in receivership funds” (20 Jul 2026)therealdeal.com
- Receiver’s Status Report, SEC v. Kapoor, Case No. 23-24903-CIV-JB, S.D. Fla. (filed 10 Sep 2025) — source for the gutted-floor quotes, construction-cessation date, $28.2M proposed sale, subsidiary-entity structure, and Unsafe Structure Panel citation; read directly via the https://r.jina.ai/ text-proxyftp.kttlaw.com
- Kozyak Tropin & Throckmorton — Location Ventures Receivership case page (SEC v. Kapoor, Case No. 23-24903-CIV-JB, S.D. Fla.; names URBIN Coconut Grove Partners LLC among the receivership entities; checked 24 Aug 2026)kttlaw.com
- Miami-Dade County Property Appraiser — Property Search (3162 Commodore Plaza, 48 folios, COMMODORE CENTRE CONDO, retrieved 24 Aug 2026)miamidadepa.gov
Questions about Urbin Coconut Grove?
Ask Josh Stein about the building’s history, the land record, or the receivership.
Thinking about Urbin Coconut Grove?
I have sold South Florida property since 2002, more than $1 billion of it. Ask me for the recorded declaration, what has genuinely closed, or a straight answer on whether this building fits what you are after.
